Refractory lining is expensive. The installation labor alone makes it one of the higher line items on any heater or vessel turnaround. The dry out is the last step before the system goes into service — and it’s the one that gets compressed when a schedule gets tight.
That’s usually when the damage happens.
Technical Resource
The Complete Guide to Refractory Dry Out
Everything fabricators and plant managers need to know about refractory dry out — moisture types, temperature schedules, steam delays, documentation, and how to evaluate a contractor.
Read the Complete GuideWhat “Rushing” Actually Means
A proper refractory dry out follows a controlled temperature ramp with deliberate hold stages. The schedule exists for a reason: freshly installed refractory contains two distinct types of moisture, and each one has to be removed under controlled conditions.
Free water — the moisture left over from the mixing and installation process — starts leaving the refractory matrix around 200°F to 250°F. That part is relatively forgiving. The more critical stage is removing chemically bound water, which is tied up in the molecular structure of the refractory material itself. That doesn’t release until temperatures climb higher, and it has to happen gradually.
When you compress the schedule, you compress those hold stages. The heat-up rate increases. Steam generates inside the lining faster than it can escape through the weep holes and the refractory surface. Pressure builds inside the matrix.
The refractory cracks.
What the Damage Looks Like
The failure modes from a rushed dry out range from cosmetic to catastrophic, depending on how badly the schedule was compressed and what type of refractory was installed.
| Failure Mode | What It Looks Like | Severity |
|---|---|---|
| Surface cracking | Fine cracks across face of lining — outer surface set while moisture was still trapped beneath | Moderate — lining looks intact but has lost structural integrity |
| Spalling | Sections fracture and separate from the surface | Serious — contamination risk, hot spots on shell |
| Delamination | Entire lining or large sections separate from the substrate | Catastrophic — installation must be torn out and redone |
None of these failures show up immediately in every case. A lining that looks acceptable after a rushed dry out can fail after the first few operating cycles when thermal expansion finds the weak points.
Talk to the Owner Directly
James Benefield
Owner, Gulf Coast Combustion
Call or text — James answers personally. No receptionist. No call queue. No waiting on a callback from someone who wasn’t on the last job.
Why Schedules Get Compressed
It’s almost always a turnaround deadline. The refractory crew finishes late. The unit needs to be back online. The dry out schedule looks like the easiest place to find time.
It isn’t.
Partial vs. Full Dry Out
Not every dry out is the same. Both partial and full dry outs depend on the refractory manufacturer’s recommendations and the customer’s specifications. Full dry out is typically what’s required to get equipment back in service. A partial dry out takes the refractory to a defined point based on those same inputs. Understanding which one is required before the job starts is part of doing it right.
Every Job Is Different
The dry out schedule — temperatures, ramp rates, and hold times — is dictated by the type of refractory, the thickness of the lining, and the application. Refractory can range from 1″ to 15″ thick, and that alone changes the equation significantly. Castable refractories, plastic refractories, and brick systems all have different requirements. The manufacturer’s recommendations are always the starting point, and GCC builds the execution plan around those specs before anyone shows up on site.
The Steam Delay: What It Is and Why It Matters
One thing that catches people off guard is the steam delay. During a dry out, if steam appears at any hold stage, the process stops and holds at that temperature until the steam is completely gone. That pocket of moisture has to be fully driven out before the cycle advances. It’s not a judgment call — it’s a required part of proper execution. Skipping it or pushing through is how refractory lining fails.
Critical Protocol
The Steam Delay Is Not Optional
If steam appears at any hold stage, the dry out cycle stops completely and holds at that temperature until every trace of steam is gone. That pocket of moisture must be fully driven out before advancing. Pushing through is how refractory lining fails — and the lining may look fine until the first few operating cycles find the weak points.
GCC documents any steam delays in the job record as a standard part of the heat treatment report.

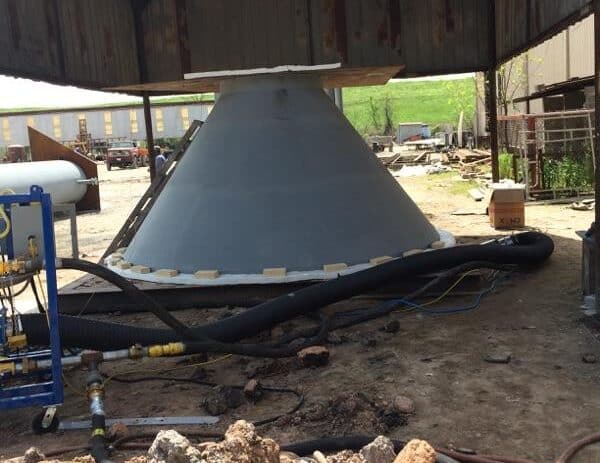

How Gulf Coast Combustion Executes a Dry Out
Gulf Coast Combustion performs refractory dry outs using high-velocity gas combustion systems, which give precise control over heat-up rates and hold temperatures across the full range a dry out may require. We provide complete chart recorder documentation of the entire process — every hold stage, every temperature ramp, and any steam delays — so you have a permanent record that the schedule was followed correctly.
If you’re planning a refractory installation and need a dry out performed, reach out early. Getting us involved before the installation is complete allows us to review the planned schedule and make sure we have the right equipment staged and ready when the installation crew wraps up.
What GCC Provides on Every Dry Out
Strip chart recorder trace — every hold stage, temperature ramp, and steam delay documented
NIST traceable calibration certificate — confirming recorder accuracy
Execution plan — submitted for client approval before work begins
Job report — permanent record for quality assurance and manufacturer warranty
Learn more about our refractory dry out services.
Gulf Coast Combustion performs refractory dry outs across Texas, Louisiana, and the Gulf Coast industrial corridor — and mobilizes anywhere in the contiguous United States. Primary markets include Houston, Beaumont/Port Arthur, Corpus Christi, Midland/Odessa, and Baton Rouge. For the full list, see our service areas page.
